Two missed
go-lives.
No third.

A $300M specialty manufacturer was 14 months into a 12-month Dynamics 365 program. Budget 60% over. Internal PM resigned. The board's question had shifted from “when does it go live” to “should we write this off.” We audited it in two weeks, told them the one thing nobody wanted to hear, and took it to go-live five months later.

Client

$300M specialty manufacturer. 14 months into a 12-month implementation, two missed go-lives.

Platform

Microsoft Dynamics 365 F&O, with the original systems integrator kept on the build.

Role

Two-week independent audit, then program takeover: re-baseline, SI renegotiation, UAT rebuild, cutover.

Timeline

Audit to leadership in 2 weeks. Live 5 months after takeover.

Outcome Measured, sources in the table below
$240Kin disputed change orders withdrawn or credited
62 → 4open defects across the final 8 weeks of testing
5 motakeover to live, with no third missed date
0lost production days at cutover
The situation Unfixable from inside

Both sides were blaming each other. Both were partly right.

Fourteen months into a twelve-month program. Go-live missed twice. Budget 60% over and climbing, because waiting is billable too. The internal PM had resigned. The integrator blamed the client's data; the client blamed the integrator. Both were partly right, which is exactly why it could not be fixed from inside.

The industry math on a full write-off is brutal: recovering a failed ERP averages 150 to 200% of the original budget (Rand Group). The window to avoid that math was closing.

The two-week audit interviewed everyone, client team, department heads and the integrator, and read all 38 open change orders. Four findings carried the program's weight: nobody owned decisions, so the integrator kept building against assumptions. Several change orders covered work arguably in the original scope. UAT had never been resourced beyond “business users will test.” And the data problem was real but bounded: a six-week problem being treated as the excuse for six months of drift.

What we did The unpopular recommendation first
  • Delivered the audit as written. Including the finding nobody wanted: go-live had to move eight weeks further out than anyone hoped. That recommendation, made in week two by someone with no history to defend, is what saved the program.
  • Re-baselined honestly. One plan, dated, with named owners on every open decision.
  • Renegotiated from the audit's findings. $240K of the 38 disputed change orders withdrawn or credited. The rest tied to phase gates going forward. Framed on evidence, not blame, because the same integrator has to maintain the system after go-live.
  • Bounded the data problem. A six-week sprint with daily reconciliation. After that, no longer available as an excuse.
  • Rebuilt UAT as a real workstream. Scenarios from production orders, a defect triage board, a daily 15-minute standup through test cycles.
  • Ran cutover like a rescue should. Full rehearsal, rollback plan, war room staffed through the first two weeks of production.

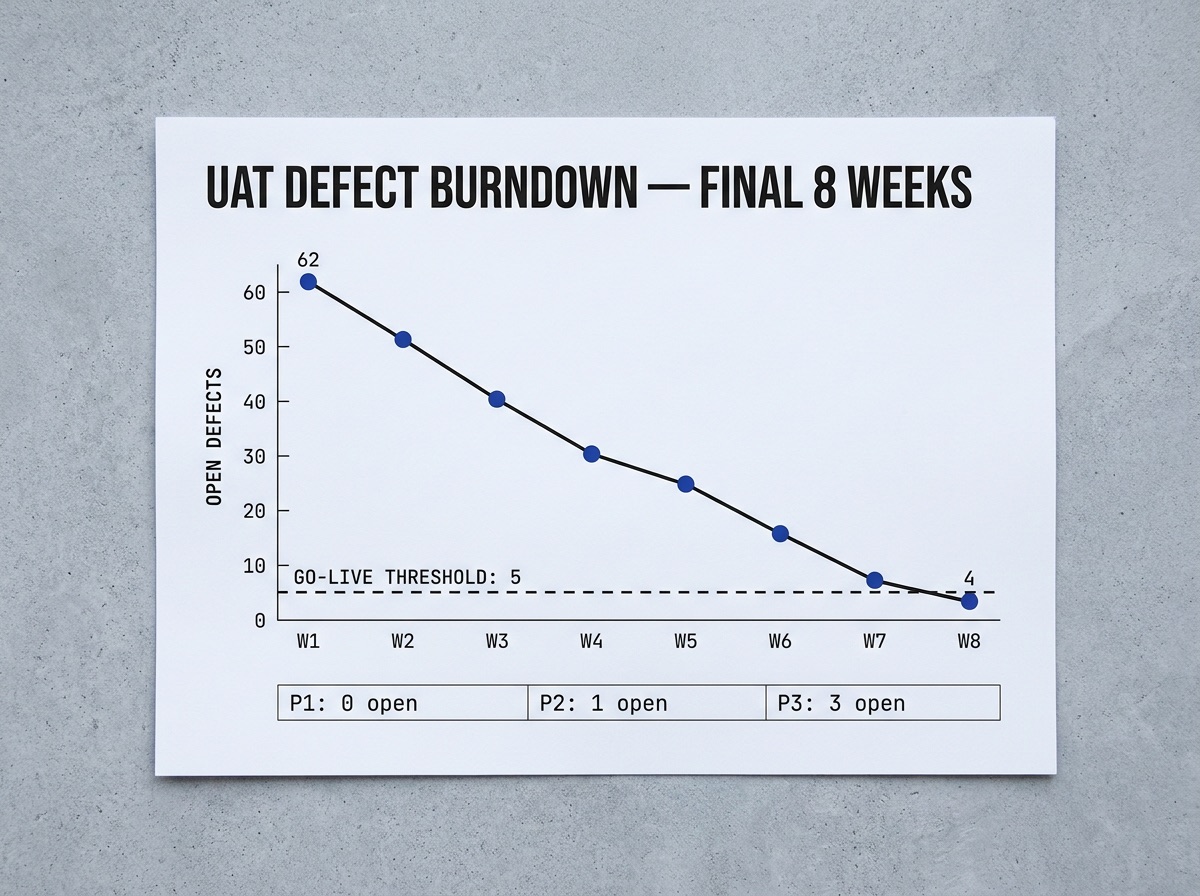

UAT defect burndown chart: open defects falling from 62 to 4 across the final eight weeks of testing, against a go-live threshold of five
Exhibit 1Defect burndown, final 8 weeks, anonymized
The program decision log with owners, age in days, and status; aged decisions highlighted
Exhibit 2Decision log after re-baseline, anonymized
The takeover sequence with exit gates
StageWhat happenedExit gate
Independent audit, 2 wksAll-party interviews, change-order review, plan-versus-reality analysisFindings to leadership
Re-baselineHonest plan, decision log, named owners, the 8-week extensionBoard sign-off
SI resetChange-order renegotiation, phase-gated payments, weekly deliverable QAAmended commercial terms
Data sprintThe six-week data fix, run as a sprint with daily reconciliationMigration reconciled
UAT rebuildProduction-order scenarios, triage board, daily standupUAT signed off
Cutover & hypercareRehearsal, rollback plan, 2-week war roomStabilized & handed off
Measured results And one that does not fit a table
MetricAt takeoverAt closeHow measured
Audit turnaround—2 weeks, all parties interviewedEngagement record
Disputed change orders38 open$240K withdrawn or credited; remainder phase-gatedAmended SI commercial terms
Missed go-lives2No third; live 5 months after takeoverProgram record
Open defects624, none blockingDefect log, final 8 weeks
Production days lost at cutover—0Production and cutover logs

The result that matters most is the one that does not fit a table: the integrator relationship survived. The renegotiation ran on findings, not grievances, and the same partner maintains the system today. Replacing an SI mid-program costs six months. Nobody paid that price.
